| |
The left frame of the Gantt chart presents a table that lists the individual activities that are present
under the selected node of the PPR process list.
- To the right of each activity is a number of columns displaying selected activity properties. The number of
columns displayed can be configured by the user. You can make other
changes to the appearance of the Gantt chart by selecting the chart
lines and dragging them to the desired size. Such changes
remain from V5 session to V5 session.
- Activities may be directly selected in the Gantt chart. Any selected activity is simultaneously highlighted
in the 3D inventory viewer and PERT chart. Similarly, if you
select in the Gantt chart a resource associated with the activity,
it is highlighted in the PPR tree and in one the 3D geometry.
Conversely, if you have the Gantt chart open and select a resource
on the PPR tree or geometry, the resource cell is highlighted in the
Gantt chart. Any objects that are not visible in the PPR tree
because the leaf showing the object is collapsed so that only the
parent node is visible are represented by a highlighted parent node.
- Right-click on an activity and select Properties to display the activity properties window.
The right frame provides a graphical representation of each process along the line of time, which also
indicates the start, duration and end of each.
- When the option to compare the roll-up time of the parent is enabled, a parent activity will have two bars
in the right frame-a gray bar representing the specified cycle time, and a blue
or red summary bar, which represents
the roll-up times. The summary bar is normally blue, but becomes red if the roll-up time is
greater than or equal to the specified cycle time for the
parent:

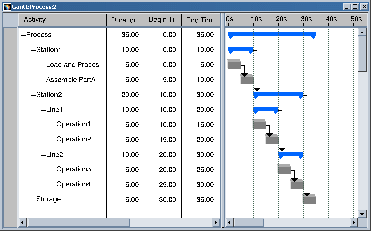

- Arrows pointing from the end of one activity to the beginning of another (as shown in the image above)
indicate sequence links from one activity to another. Such sequence links can be created or deleted via the
standard Link Activity command (see Basic Tasks > Editing a Process Plan > Linking Activities).
- When running a simulation, a dashed vertical line in the right window (called the Time Line), provides a
visual indication of the current time during the execution of a process, and continuously updates its location
according to the simulation or process verification clock. The Time Line will appear automatically when a
simulation or process verification is launched.
|
